Inspection
Work Planning

This is some text inside of a div block
Case Study

Valve Labeling at Scale

How we labeled 15,000+ manual valves across 270 P&IDs in just two weeks
Download PDF
Intelligent Drawing Platform
15,237
Valves labeled
270
P&IDs processed
14
Days completed
Faster delivery
Figure 01
Figure 02

01The Challenge

A major industrial facility running the Intelligent Drawing Platform needed sequential numbering on every manual valve in the operation. The labels weren't cosmetic — they were the backbone of operating procedures and lockout/tagout safety protocols. Every P&ID required its own independent sequence starting from 001, across six valve types: gate, globe, ball, butterfly, needle, and 3-way.

The manual math: 480–640 person-hours over three to four months of drafting, with error rates in comparable manual operations exceeding 2% — three hundred wrong valves in safety-critical LOTO procedures.

02The Approach

1

Valve identification

IDP's pattern recognition identified every manual valve instance across all 270 drawings, distinguishing six valve types and excluding automated control valves from scope.

Output: 15,237 valves identified
2

Identifier mapping

Sequential numbers assigned algorithmically per drawing, from 001 up — automated validation guaranteeing no duplicates and no gaps in any sequence.

Output: Validated mapping table
3

Automated insertion

Labels written programmatically into the AutoCAD masters as symbol attributes on dedicated layers — native drawing data, not overlays.

Output: 270 updated P&IDs

03What Changed in the Field

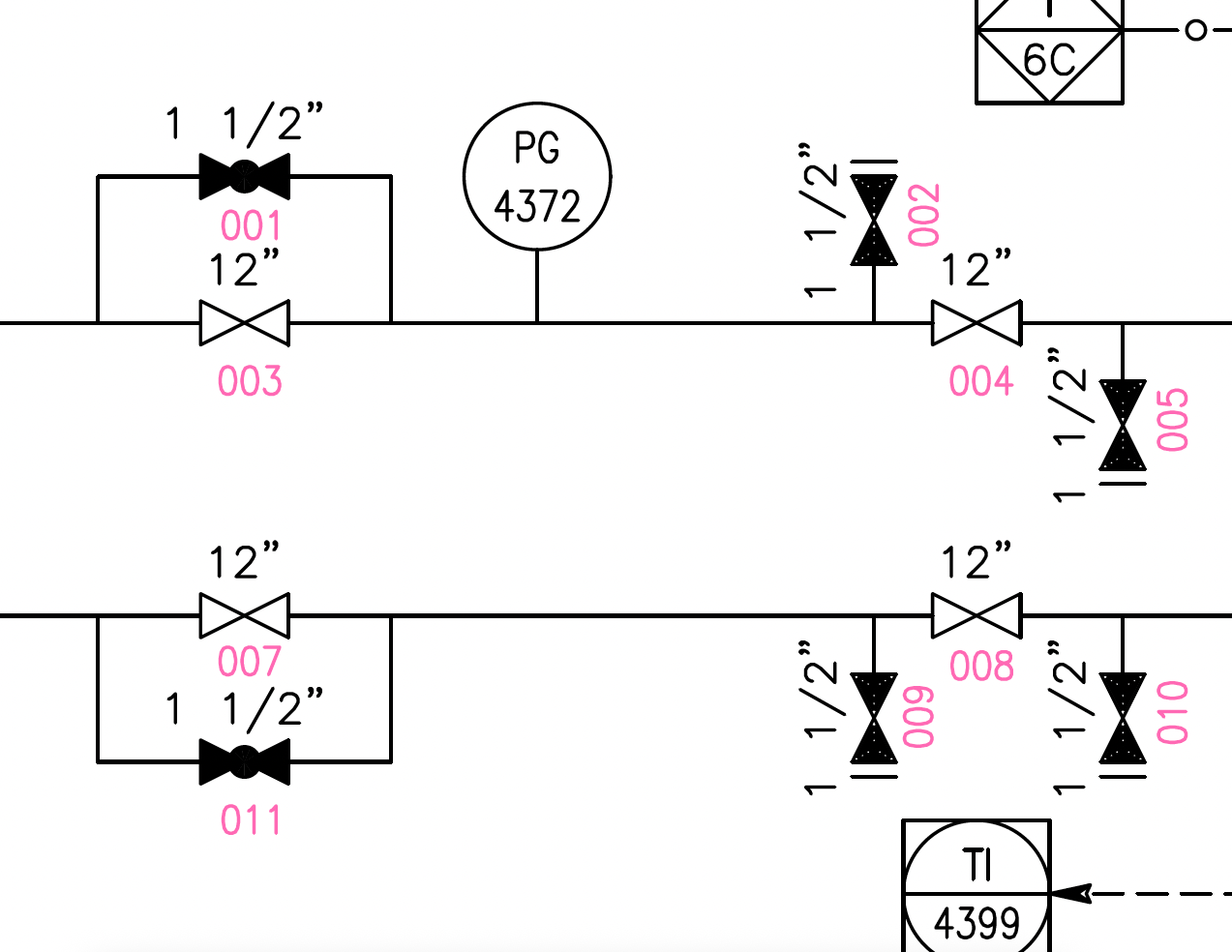

Before labeling, a procedure read: "Close the valve downstream from vessel 6C before the temperature indicator." After: "Close valve 002."

Clear LOTO procedures

"Lock out valves 003, 004, and 008" replaces descriptive text.

Faster maintenance

Technicians locate valves instantly by unique ID.

Reduced training time

New operators reference numbers, not tribal knowledge.

Emergency response

Critical valves identified immediately in shutdown procedures.

04By the Numbers

MetricTraditionalAutomatedImprovement
Timeline112 days14 days8× faster
Person-hours6406091% reduction
Error rate~2%0%100% accuracy
Cost$48,000$4,50090.6% savings
